The strongest web agency proposal is not necessarily the cheapest or most detailed. Learn which signals reveal strategic understanding, delivery capability and a partnership built to last.
Two agencies can both quote a 16-week website project, yet one may include content migration, analytics validation and post-launch support while the other starts charging for them as soon as the contract is signed. That difference is easy to miss when polished templates and AI-assisted development make very different suppliers appear equally capable on paper. For business leaders, marketing managers and digital project owners, the real comparison is therefore not headline price but the evidence behind the promised outcome, schedule and operating model. A disciplined review reveals whether an agency can translate commercial goals into measurable work, manage delivery risk and leave the business with a website it can afford to operate.

Does the proposal translate business goals into testable website outcomes?
A strategically credible proposal creates traceability from each business objective to a user journey, a website intervention and an observable result rather than repeating the brief with promises of a modern design. If the objective is to increase qualified demo requests, for example, the proposed response might combine clearer audience segmentation, stronger proof content, a shorter form and CRM fields that distinguish sales-ready enquiries from general contact requests. The measurement plan should record the current baseline, the target, the event being measured, the responsible data owner and the tools used, such as GA4 for journey analysis and HubSpot for confirming lead quality. A statement such as “improve engagement” is not testable until it is tied to signals such as completed quote requests, product-document downloads, recruiter applications or repeat visits from a named account segment. The agency should also expose assumptions that discovery must investigate, including whether weak conversion is caused by unclear positioning, poor traffic quality, missing evidence or form friction, because each diagnosis leads to different priorities and costs.
The delivery plan matters more than the portfolio
A portfolio proves that an agency has released attractive websites, but it rarely identifies who completed the work, how difficult decisions were handled or whether the launch date and budget survived contact with reality. Test delivery credibility by asking for the names, responsibilities and expected allocation of the project lead, strategist, designer and technical lead, distinguishing full delivery team members from senior specialists who appear only during the pitch. A believable plan also exposes client and third-party dependencies, including content delivery, stakeholder approvals, legal review, integration credentials, DNS access and the time needed to test migrated data. In a 16-week schedule, design approval in week six cannot be treated as an isolated milestone if delayed copy prevents templates from being validated or if security review must finish before integration testing can begin. Ask for a recent reference with comparable complexity, such as a multilingual migration or Salesforce integration, and verify what changed between the original scope, final budget and actual launch date.
Find the missing scope before it becomes a change request
Proposal totals become misleading when one agency prices a production-ready launch while another prices design and development with operational necessities left undefined. Convert every submission into the same scope matrix, covering discovery, information architecture, copywriting, asset production, content entry, redirects, integrations, browser testing, accessibility review, analytics configuration, training and warranty support. Replace labels such as “SEO-ready,” “accessible” and “CRM integration” with acceptance criteria that state who creates the redirect map, which WCAG level will be tested, which browsers are covered and whether form data is mapped to CRM fields with validation and error handling rather than simply emailed. Content migration requires similar precision: record the number of pages and assets, supported templates, metadata treatment, file cleanup, multilingual variants and ownership of manual corrections after import. Any item that remains undefined should receive an owner, an assumption and a likely cost range before proposals are scored, preventing an apparently low fee from winning through omissions.

Calculate long-term value from the operating model, not the launch price
The launch fee is only a snapshot of value because routine changes, proprietary hosting, licence renewals and slow support can make the cheapest build the most expensive option within three years. During selection, ask each agency to demonstrate how an ordinary editor creates a campaign page, changes navigation, schedules content and restores a previous version without developer help, then estimate the internal time those tasks will consume. Build a three-year total cost of ownership covering implementation, CMS and plugin licences, hosting, maintenance, support retainers, expected change requests and internal administration rather than comparing project fees alone. Support quality should be made measurable through response and resolution targets, escalation routes, included monthly capacity, rollover rules and the cost of common requests such as a new landing-page template. Review exit conditions before signing by confirming ownership of source code, design files and data, direct access to repositories and hosting accounts, export options, documentation standards, credential transfer and notice periods.
Compare the Delivery Model, Not Just the Agency Fee

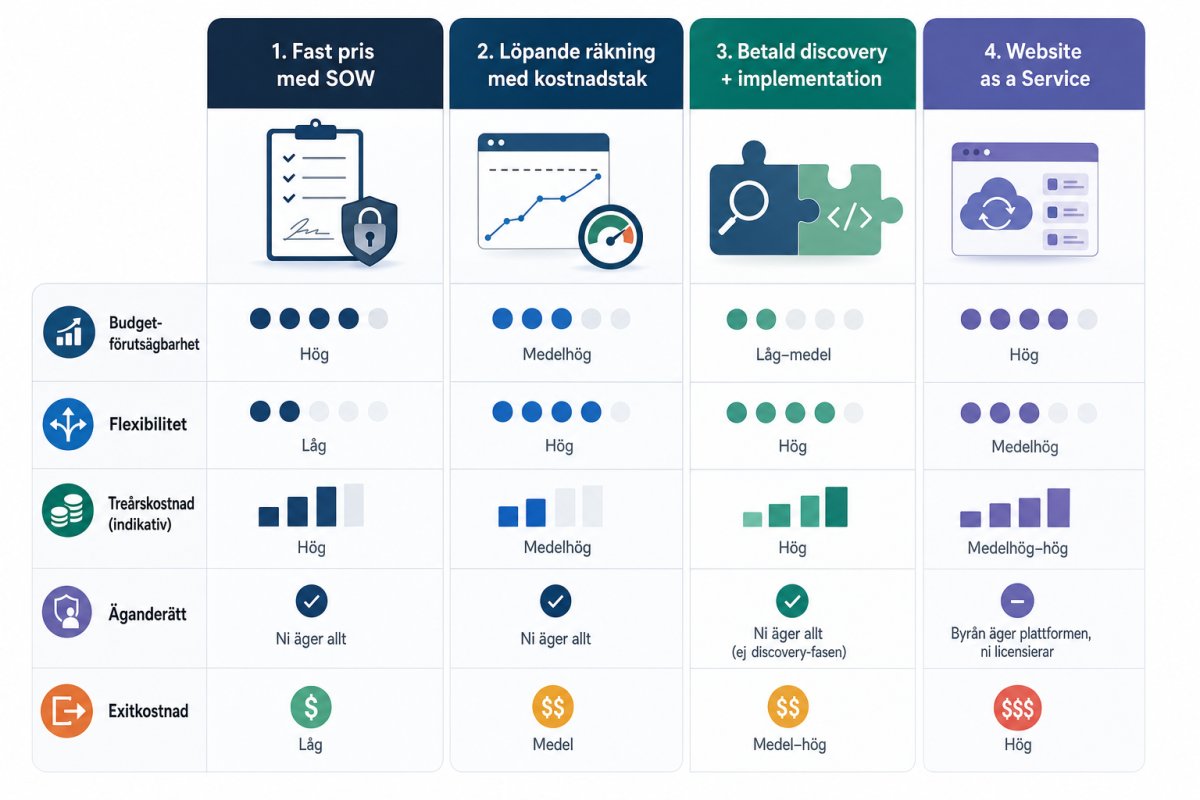

Agency proposals usually rely on one of four commercial and delivery models, each placing budget risk, scope uncertainty and decision-making responsibility in a different place. Compare how the models support measurable outcomes, changing requirements and post-launch improvement before comparing totals. The right choice depends on how well the requirements are understood and whether the client can make timely, evidence-based decisions.
Fixed-Price Statement of Work (SOW)
A fixed-price SOW converts documented requirements into a defined set of deliverables, milestones and acceptance criteria, giving procurement a clear amount to approve.
- Provides budget certainty when integrations, migration volumes and acceptance criteria have been documented in detail.
- Makes bids easier to compare when every agency prices the same scope and lists exclusions explicitly.
- Undefined migration, analytics, accessibility or CRM edge cases commonly return as paid change requests.
- The agency is rewarded for delivering the agreed feature list even when testing indicates that different work would create more value.
Best for: A technically understood website with stable requirements, limited integrations and an internal owner able to approve detailed scope.
Time and Materials with Scrum
This model buys team capacity rather than a fixed feature set, allowing the backlog to respond to research, testing and technical discoveries during delivery.
- Priorities can change after user testing or analytics findings without renegotiating the entire contract.
- Sprint reviews, backlog visibility and velocity data make progress easier to inspect than a high-level timeline.
- The final cost remains variable, and weak backlog ownership can consume substantial budget without producing a coherent release.
- Completing many tickets does not guarantee better conversion, lead quality or editorial efficiency.
Best for: Organisations with an engaged product owner, uncertain requirements and enough budget flexibility to make evidence-based trade-offs.
Discovery-First Engagement
Discovery separates problem definition from build commitments, creating space to test assumptions before architecture, scope and platform decisions become expensive to reverse.
- Surfaces governance, migration volumes, integration ownership, consent requirements and other missing scope before build pricing.
- Can turn broad goals into baselines, target events, prioritised journeys and an agreed measurement plan.
- Upfront research may produce presentations rather than a usable backlog, prototype and technical recommendation.
- The eventual build price may still rise, and findings may be difficult to reuse if ownership terms are restrictive.
Best for: Redesigns involving several stakeholder groups, unclear user needs, legacy platforms, substantial migration or complex integrations.
Continuous Product Retainer
A product retainer treats launch as the start of an operating cycle that includes monitoring, maintenance, experiments and incremental improvements.
- Connects delivery to ongoing Core Web Vitals monitoring, conversion testing, dependency updates and accessibility fixes.
- Makes support capacity, response expectations and improvement costs visible instead of hiding them beyond launch.
- Monthly capacity can be wasted when the client lacks a prioritised roadmap, reliable analytics or timely approvals.
- Long notice periods, proprietary components and agency-controlled hosting can create supplier lock-in.
Best for: Commercially significant websites requiring regular optimisation, campaigns, integrations and dependable technical ownership.
A discovery-first engagement followed by transparent time-and-materials delivery is usually the strongest option when outcomes or scope remain uncertain. Fixed price can suit predictable work, while a product retainer creates long-term value only when capacity, service levels, ownership and exit terms are clearly defined.
Pressure-test each proposal before you shortlist
-
Convert business goals into a one-page measurement contract
Ask each agency to map the top three goals to a baseline, target, data source, owner and review date. A useful commitment might be to increase qualified demo requests from 35 to 50 per month within 90 days of launch, with HubSpot confirming lead quality and GA4 recording the journey. Reject outcomes such as “improve engagement” unless the audience segment, event and success threshold are named.
-
Score the delivery plan before reviewing the portfolio
Create a weighted scorecard in Google Sheets with delivery approach at 30%, team and availability at 20%, scope completeness at 20%, operating model at 20% and portfolio at 10%. Require a week-by-week plan covering discovery, content deadlines, design approvals, development, migration, quality assurance and launch ownership. Check that named specialists have realistic allocations rather than appearing only in pitch biographies.
-
Run a 60-minute scope-gap workshop with every finalist
Use the same Notion or Excel checklist for content entry, redirects, analytics, cookie consent, accessibility, SEO metadata, CRM forms, integrations, hosting, browser testing, training and post-launch fixes. Force every item into one of four categories: Included, Excluded, Client-owned or Assumption. Request cost ranges for likely additions, such as €1,500–€3,000 for multilingual migration, so undefined work becomes visible in the comparison.
-
Test the proposal with three realistic change scenarios
Ask what happens if stakeholder approval is delayed by 10 working days, the site gains 20 pages or a required Salesforce integration is discovered during research. Require written estimates of the effect on cost, launch date and team availability. The answers reveal whether change control follows agreed rules or defaults to open-ended billing and schedule drift.
-
Compare three-year operating cost, not launch price
Build a 36-month model that includes hosting, CMS licences, plugin renewals, support, security updates, minor improvements and internal labour, such as 10 staff hours per month at €60 per hour. Add median support response times, included monthly hours, rollover rules and the price of a typical campaign page. This comparison shows how each operating model affects both expenditure and the speed of routine marketing work.
-
Verify the handover and exit path before signing
Require confirmation that your company owns or directly controls the GitHub repository, Figma files, analytics accounts, domains, deployment credentials and reusable components from day one. Ask the agency to price an exit package containing documentation, environment setup, a dependency inventory and a two-hour technical handover. Refusal, proprietary restrictions or ambiguous account ownership indicate future switching costs that belong in the evaluation.
Use the same scorecard, scope checklist and three-year cost model for every agency so persuasive presentations cannot hide delivery risk. The strongest proposal will make outcomes measurable, responsibilities explicit and ongoing change affordable before the contract is signed.
